Noble Walker – Port Said (Suez) - Egypt- System Upgrade, Fleet Edge Deployment & VSAT/FBB System Validation
Field Dispatch - Noble Walker
Port Said (Suez) →Egypt | 6–8 October 2025
Project Summary
Global Satcoms successfully completed the service Modify, Add, Change (MAC) onboard Noble Walker , upgrading several components of the vessel’s existing communication infrastructure.
The intervention included removing outdated hardware, installing a new Fleet Edge (DELL), reconfiguring satellite communication paths, activating a new FBB SIM, installing a new IP phone, and validating VSAT, voice, and FBB services.
Despite significant port delays and overnight work, the project was completed within the vessel’s operational window.
Vessel: Noble Walker
Location: Port Said (Egypt)
Service Dates: 6–8 October 2025
Service Scope :
-
Modify: Removal of Dell server & Cisco router
-
Add: Installation of Fleet Edge (DELL)
-
Add: New IP phone installation
-
Change: New FBB SIM activation & configuration
-
System verification: VSAT, FBB, GX failover & voice testing
-
Network integration & remote configuration support
Challenges & Operational Constraints
-
Engineer faced a 9-hour delay at port before boarding approval.
-
Boarding occurred at 4:30 AM, requiring work to continue through the night.
-
Boarding was performed at anchorage, requiring timing alignment with the agent.
-
Missing AC cords prevented the removal of the existing power management controller.
-
Tasks required completing the MAC modifications within a limited and unpredictable access window.
Work Completed

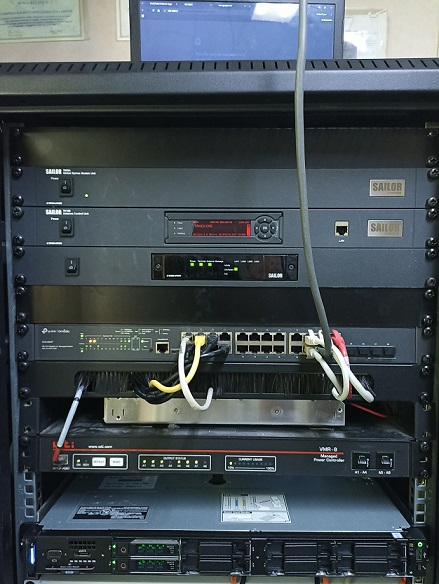

The engineer performed all required MAC modifications, including:
-
Inspection of current and client-provided equipment
-
Removal of Dell server and Cisco router
-
Installation and activation of the new FBB SIM card
-
Enabling remote access for configuration
-

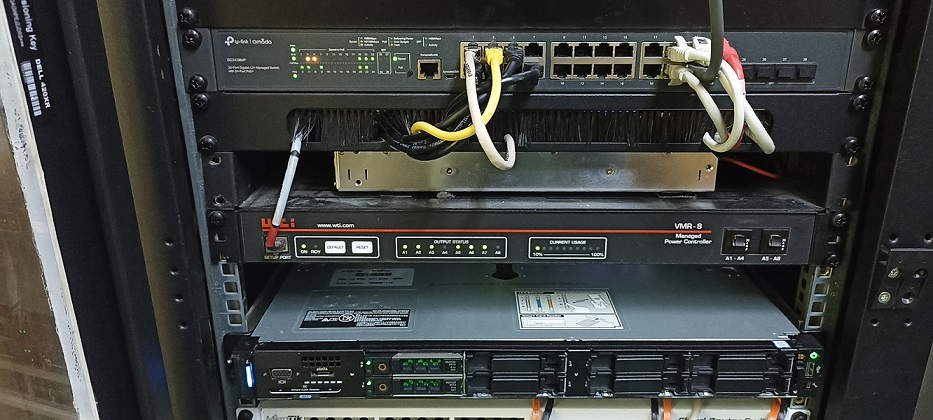

Installation of Fleet Edge (DELL) and associated cabling
-
Installation and configuration of the new IP phone
-

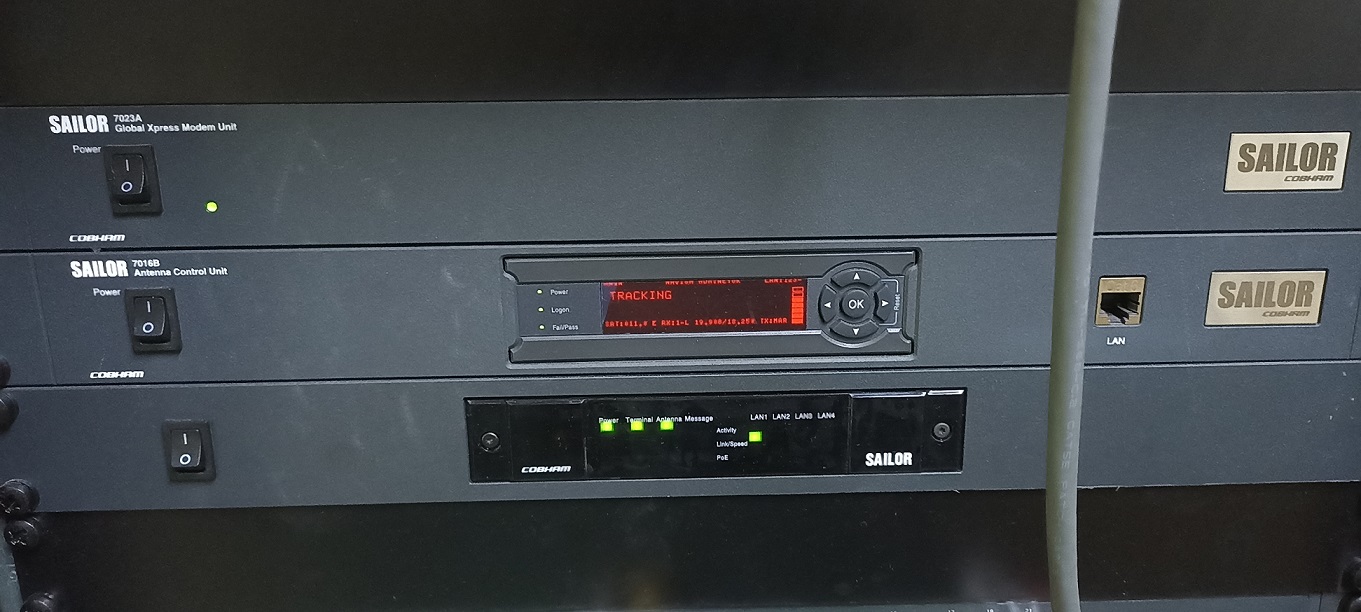

Testing of VSAT (good performance)
-
Testing of FBB (working well post-SIM activation)
-
Voice testing – successful
-
GX ↔ FBB failover test – successful
-
Final documentation and captain sign-off
Summary of Activities
6 October 2025
-
19:00 – Travel from home city to port
-
23:00–04:30 – Awaiting boarding clearance at port (agent delay)
7 October 2025
-
04:30 – Boarding at anchorage after agent’s green light
-
Inspect existing equipment and share details with Support
-
Remove Dell server and Cisco router
-
Install new FBB SIM card and activate
-

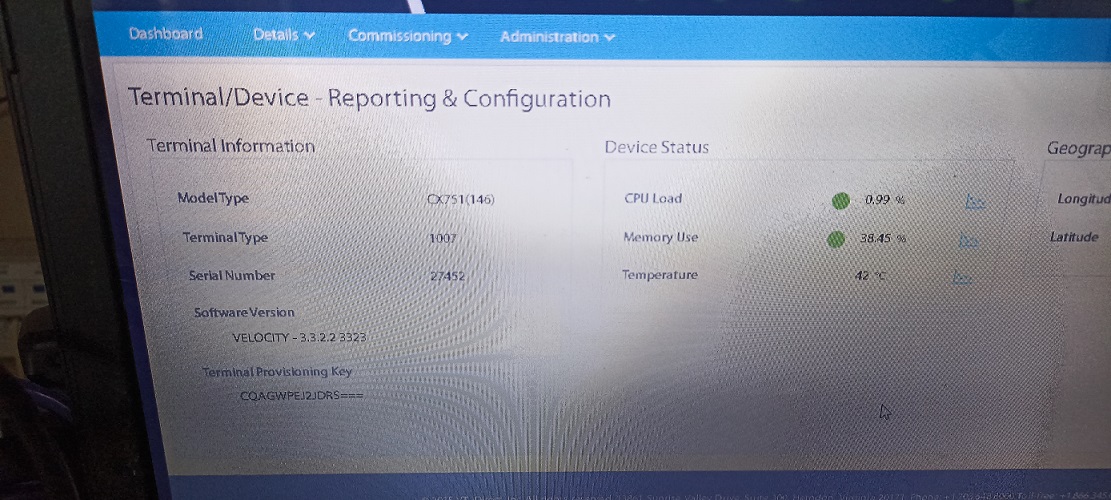

Configure FBB with remote support
-

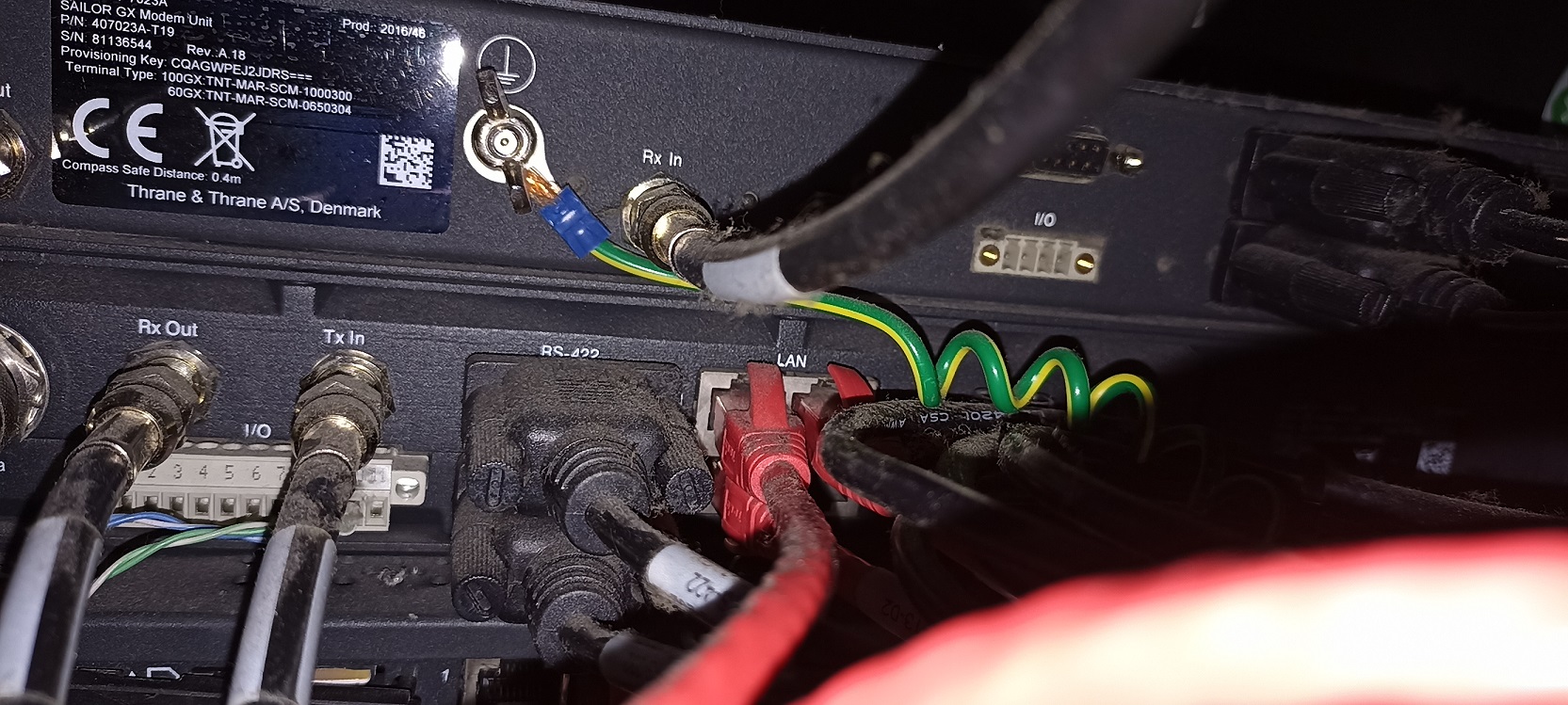

Install Fleet Edge (DELL) and connect cabling
-
Install and configure new IP phone
-
Unable to remove old power controller (missing AC cord)
-
Test VSAT, FBB, voice – all successful
-
Failover between GX and FBB tested successfully
-
Prepare and sign final report
8 October 2025
-
08:00–12:00 – Travel back home from Suez
System Status
| System / Equipment | Status | Notes |
|---|---|---|
| Fleet Edge (DELL) | Operational | Fully installed & configured |
| FBB Inmarsat | Operational | New SIM activated |
| IP Phone | Operational | Configured & working |
| VSAT | Operational | Stable connectivity |
| GX ↔ FBB Failover | Successful | Seamless redundancy |
| Power Controller | Not Modified | Missing AC cords prevented removal |
Notes & Recommendations
-
Replace the missing AC cords to complete removal of the old power controller.
-
All communication systems (VSAT, FBB, voice) are functioning correctly.
-
Failover performance is stable and provides reliable redundancy.
-
Any future MAC tasks should include verification of all power accessories prior to dispatch.
Lessons Learned
-
Port and agent delays require contingency planning.
Long waiting times significantly reduced productive hours and should be anticipated for future calls. -
Missing hardware accessories delay full MAC execution.
AC cord availability should be confirmed before equipment removal tasks. -
Overnight operations require strong coordination.
Completing work between midnight and sunrise necessitated efficient planning to avoid fatigue-related delays. -
Failover validation is crucial in MAC upgrades.
GX–FBB switching tests ensured the new configuration functions as intended. -
Pre-deployment equipment verification prevents gaps.
Reviewing client-supplied equipment and accessories beforehand prevents incomplete tasks.
Service Outcome
-
MAC service (Modify, Add, Change) successfully completed.
-
Fleet Edge installation and system upgrades delivered as planned.
-
All communication services—VSAT, FBB, voice, and failover—validated and working.
-
Report signed and acknowledged by the captain.
-
Noble Walker now benefits from updated, stable, and fully validated communication infrastructure.
